Custom Wooden Box Manufacturing: From Glue-Up to Final Inspection

A custom box order passes through eight stations between the lumber yard and the pallet. This is what happens at each one, what the QC checklist tests, and what a buyer should ask to see.

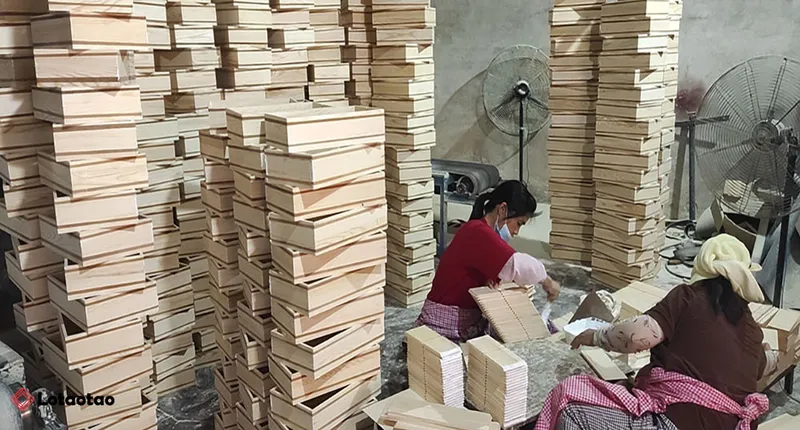

Workers applying glue and assembling wooden box frames by hand at the start of production

Where a Custom Box Order Starts

The order that reaches the floor is 8,000 lined gift boxes with a hinged lid and a combination lock, 260 × 180 × 70 mm, walnut veneer over plywood for the lid and solid poplar for the frame. The buyer sells into northern Europe. That single sentence — northern Europe — fixes the moisture target at 8–12 percent and rules out several finishing options before anyone cuts a panel.

Most sourcing conversations stay at the level of dimensions, material and unit price. The variables that decide whether 8,000 boxes arrive usable are decided later, at stations the buyer never sees: the moisture meter at goods-in, the defect saw, the clamp rack, the rest period between glue-up and hardware, and the sampling plan at final inspection.

This is the route the order takes through the plant, in sequence.

Lumber In, Moisture Metered

Every bundle gets checked at goods-in: species against the purchase order, grade, and moisture. Species identification is a macroscopic check against a reference set for the common substitutes — poplar against tulipwood, walnut against the African species sold under similar names. A grade error caught here costs a phone call. The same error caught after assembly costs the order.

Moisture is measured with a resistance meter at three points per board, probes driven to a third of the board thickness, reading across the grain. Pin meters are accurate to about ±1–2 percent after temperature and species correction, which is enough to catch a wet bundle and not enough to certify a kiln charge. The correction matters: a board at 8°C reads about 6 percent high against a 20°C calibration, so an uncorrected winter reading sends dry lumber back to the kiln.

Kiln charges are checked at 100 percent on exit and then conditioned a minimum of 72 hours before the kiln operator signs them off. The conditioning step releases the stress gradient between the shell and the core. Skip it and the board machines flat, then cups two days after it reaches the assembly room.

The target is set by where the box will live, not by what the kiln finds easiest:

  • 6–10 percent for US indoor markets
  • 8–12 percent for northern Europe
  • 10–14 percent for southern China
  • 12–16 percent for Southeast Asia

A box built at 8 percent and shipped to Singapore arrives drier than its surroundings, takes on moisture, and the lid swells. A box built at 14 percent and shipped to Minnesota dries out and opens at the mitres. The number is a destination decision, and the purchase order should state it.

Acclimation and Panel Dimensioning

Dried lumber sits in the assembly room 48–72 hours before cutting. The room holds 20–25°C and 50–65 percent relative humidity. Acclimation is not a formality: a board that comes from a cold container into a warm shop needs time for the outer few millimetres to reach equilibrium, and that outer layer is what the first machining pass exposes.

Panels are rough-cut 6 mm oversize, jointed, planed and then left overnight before the final dimension pass. The overnight wait lets the material that was removed from the faces release, so the final thickness holds instead of creeping 0.2 mm within a shift.

Defect cutting follows the board, not the cut list. Knots, pitch pockets, checks and discoloration are marked and cut out, and the offcuts go to the finger-joint line rather than the bin. Yield from dried lumber to usable parts runs 65–80 percent on a defect-heavy hardwood; a buyer comparing quoted prices between two factories is usually comparing two different yield assumptions.

Parts are then machined on the CNC: profile, groove, and joinery in one or two setups. A five-axis cell cuts the hinge mortise, the lock bore and the lid profile in a single clamp, which removes the tolerance stack that builds when the same part is handled three times.

Choosing the Joint

Three joints cover most custom box work. The choice is a cost and load question, not a craftsmanship competition.

Joint Relative tensile strength Machine time per corner Where it earns the cost
Box joint (finger) High; glue area is large 20–30 seconds Painted or lined boxes, high volume, square corners
Dovetail 150–200% of a standard right-angle tenon 60–120 seconds Visible joinery, chests, boxes that take load or get dropped
Miter with splines Moderate; spline carries most of the load 35–50 seconds Thin walls, continuous grain around the corner, veneered faces

A box joint is the default for a lined gift box. The interlock is strong, the CNC cuts it in about 25 seconds per corner, and the lining hides it. Dovetails add roughly 12–18 percent to the assembly labour on a small box and 30 percent or more on a large one, and buyers accept that when the joint is meant to be seen. Half-blind dovetails on a lid frame are a different proposition; the setup time per size is what makes small orders expensive.

Mitres with splines exist for a specific problem: a 12 mm wall with veneer on the face cannot carry a visible end-grain joint. The spline — usually a 3 mm plywood or hardwood strip set 6 mm deep — gives the corner its strength and the grain runs continuously around the box. On a thin-walled veneered box this is the right answer. On a 20 mm solid poplar frame it is decoration with extra steps.

Glue-Up, Clamping, and the Rest Period

Frames close with PVAc D3 at 180–220 g/m² spread, 0.8–1.2 MPa clamp pressure, and 45–90 minutes in the press. Full cure takes 24 hours. The assembly line runs a two-day buffer between the press and the next machining operation, and again between machining and hardware.

That second wait is the one buyers question. It looks like idle inventory. It is doing three things.

First, the moisture in the adhesive has to leave. PVAc carries water into the joint, and the surrounding wood takes it up. The glue line is dry in an hour but the wood around it is not, and a hinge screwed into a swollen stile sits 0.3 mm off position once the moisture equilibrates.

Second, the frame relaxes. Clamps hold a frame in a slightly loaded state, and the wood creeps back when they come off. A lid fitted 20 minutes after clamping has a different gap at 48 hours.

Third, finish adhesion depends on it. A film applied over a joint that is still moving cracks along the seam within a heating season. The finish does not fail because the coating is wrong; it fails because the substrate moved underneath it. Every finishing specification that lists a moisture range is really a statement about how long the wood rested.

The rest period is 24–48 hours depending on wall thickness and shop humidity, and the same logic governs the sanding and lid fitting sequence on a simpler box. Thin walls and dry winter air shorten it; 20 mm stock in a humid August runs the full 48.

Hardware, Lining and Inserts

Hardware goes on after the rest period, on a jig. Hinge cups are bored 35 mm diameter, 11–13 mm deep, with the cup centre 21–24 mm from the door edge. On a small box lid, a cup bored 1 mm deep leaves the hinge proud and the lid sits off its stop; a cup bored 1 mm shallow cracks the lid face. Both failures come from the same source: a hand-held drill instead of a jig.

Combination locks get a template as well. The lock body sits in a mortise routed to 0.2 mm clearance, the shackle plate is set flush, and the mechanism is cycled 20 times before the box moves on. The most common field failure on a locked box is not the lock — it is a lid that has to be lifted 2 mm before the shackle engages, which is a hinge alignment problem showing up at the lock.

Hardware is tested to the spec: hinges for 20,000–50,000 open-close cycles, latches for alignment under a 2.5 kg lid load, locks for 500 cycles with the correct code and 20 with a wrong one. A production sample goes through the full count once per batch; units on the line get a functional check.

Lining follows. Velvet, suede cloth or paper is cut 3 mm oversize on each edge and laid with a water-based adhesive, worked from the centre out so no air is trapped. Foam or EVA inserts are cut on a CNC knife table to a tolerance of ±0.3 mm, because an insert that is 1 mm loose lets the product shift in transit and an insert that is 1 mm tight will not seat. Our box lining guide covers the material and adhesive combinations that hold up in a humid warehouse.

The tolerance stack is the thing to watch: frame squareness, lid fit, hinge position and lining thickness all land on the same 260 mm opening. Hold each at its own tolerance and the lid can sit 1.5 mm off centre with everything in spec. This is why the jigs are built from the finished frame, not from the drawing.

Finishing and Final Inspection

Finishing starts with a wipe-down and a tack cloth, then a sealer coat, sanding at P240–P320, and two topcoats. A water-based system lays down 80–160 μm total film; a solvent PU system runs 120–200 μm. On the walnut-veneer lid the sealer also controls blotching, which is why the sealer coat goes on before any stain on that face.

Adhesion is checked by cross-cut at 1 mm spacing on a scrap from the same batch, pulled with tape at 60 degrees, following the method in our surface finishing guide. We hold class 1 for these boxes — cut edges smooth, no squares lifted. Anything at class 2 goes back for a scuff and a recoat, not out the door.

Final inspection is a 100 percent visual pass plus an AQL sample. Visual: 600–1,000 lux at 40–50 cm, A-faces (the lid top and front panel) held to the stricter limit, B-faces (sides, interior) to the looser one, C-faces (underside, inside the base) checked for function only. The sample follows GB/T 2828.1 with AQL 2.5 for major defects and 4.0 for minor. A 8,000-piece lot at general inspection level II means 200 units pulled, accept on 10 majors, reject on 11.

The checklist tests six things on every sampled box:

  1. Lid gap — 0.5–1.5 mm on all four sides, measured with a feeler gauge at the midpoint of each edge.
  2. Squareness — diagonals within 0.8 mm on a box this size.
  3. Hardware alignment — lid sits flush, latch engages without lifting, lock code turns first time.
  4. Moisture — meter reading within 1 point of the destination target.
  5. Finish adhesion — cross-cut class 1 on the sample scrap.
  6. Hardware function — 20 open-close cycles, no binding, no screw spin.

A failure on any one item sends the whole sample back for a second pull. Two consecutive failures stop the lot.

What to Ask for During a Factory Audit

An audit that consists of walking past a clean assembly line proves nothing. Ask for records, and ask to see the station that produces them while it is running.

  • The moisture log for the lumber in your order. Not a certificate for the species — the meter readings with dates, and the kiln charge number they belong to.
  • The conditioning record. The 72-hour balance after drying is the step most easily skipped, and the paperwork is either there or it is not.
  • The clamp pressure calibration tag. Pressure gauges drift. A factory that calibrates on a schedule has a tag with a date on it.
  • The diagonal check sheet. If squareness is checked, someone writes it down. Ask what happens to a frame that fails twice.
  • The AQL plan for your lot size. Sample size, accept and reject numbers, and which defects count as major.
  • A finished box from the last shipment, opened in front of you. Work the hinge, close the lid, look at the gap at each corner. Ten seconds of handling tells you more than the audit checklist.

Ask to see the rest racks. If there are no racks, or the boxes move from press to hardware in the same shift, the rest period in the quotation is theoretical. For orders where fit and finish matter, that is the single most revealing thing on the floor.

If you are starting from a drawing rather than a purchase order, our guide to placing a custom order sets out the specification details that decide all of the above before the first board is cut.

Frequently Asked Questions

Why does a wooden box need to rest after glue-up before hardware goes on?+

PVAc carries water into the joint, and the frame creeps slightly when clamps come off. A hinge screwed into a stile that is still swollen sits off position once the moisture equilibrates. We hold 24–48 hours after clamping, which also gives the finish a stable substrate. Rushing this step shows up as misaligned latches and cracked finish along the seam.

Which joint should a custom box use: box joint, dovetail or miter with splines?+

Box joints for high-volume lined or painted boxes, because they cut in about 25 seconds per corner and the lining hides them. Dovetails where the joint is visible or the box takes load, at roughly 150–200 percent the tensile strength of a standard right-angle tenon. Mitres with splines for thin veneered walls that need continuous grain around the corner.

What moisture content should a custom wooden box have?+

It depends on the destination, not the factory. Target 6–10 percent for US indoor markets, 8–12 percent for northern Europe, 10–14 percent for southern China and 12–16 percent for Southeast Asia. A box built at 8 percent and shipped to a humid market takes on moisture and the lid swells; one built at 14 percent and shipped to a dry market opens at the mitres.

What does AQL 2.5 mean on a box order?+

It is the acceptance quality limit for major defects under GB/T 2828.1. For an 8,000-piece lot at general inspection level II, 200 units are pulled and up to 10 majors are accepted; the 11th rejects the lot. Minor defects run at AQL 4.0. Ask for the sample size and the accept number in writing before production starts.

What should a buyer check in a factory audit for wooden boxes?+

Ask for the moisture log tied to your lumber, the 72-hour conditioning record, the clamp gauge calibration tag, the diagonal squareness sheet and the AQL plan for your lot size. Then open a box from the last shipment and work the hinge. The strongest signal is the rest rack: if finished frames go from press to hardware in one shift, the process in the quotation is not the process on the floor.
